CMS: Myers Park High School Expansion + Renovations

Strategic Phasing for Uninterrupted Operations

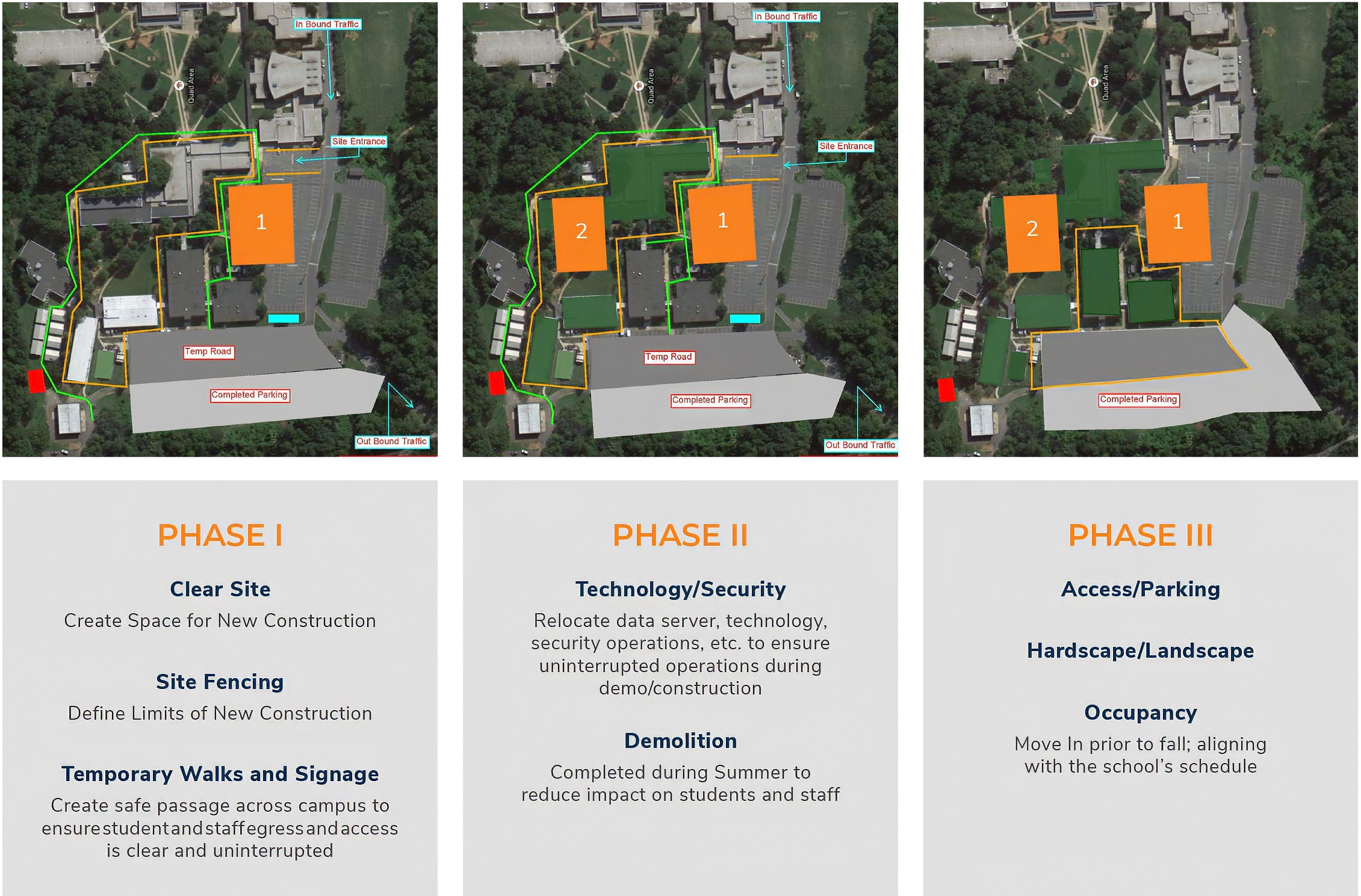

Phasing was essential for ensuring that school operations continued uninterrupted throughout the construction process. Once Building #1, the Science, Engineering, and Technology Building, was completed, the existing Language Arts building was demolished during the summer months when school was not in session. The decision to demolish the existing Language Arts Building when classes were not in session was strategically planned by our team during the early phases of design due to the fact that the school’s main data server and security operations were housed in the building, requiring the careful rerouting of wiring and the relocation of technology prior to demolition. Our team prioritizes extensive early planning for occupied construction projects on school campuses to anticipate potential disruptions to education and to ensure the safety of students, staff, and parents.

Safety Measures During Demolition

To ensure the safety of students and staff during this transition, construction fencing and traffic control measures were implemented to restrict access to the demolition area. These precautions were vital for maintaining a secure environment on campus.

Continued Development

Once Building #1 was completed, construction on Building #2, the New Language Arts Building, commenced in the former location of the old Language Arts building. Following the successful completion of Building #2, three additional buildings were demolished to expand an existing parking lot to accommodate the growing population of students and staff driving to school each day.

Challenges of Construction Traffic Management

Managing construction traffic was one of the biggest challenges this project had presented. Student parking and the occupied academic buildings were located on opposing sides of the campus, and close coordination with the construction manager and CMS was required to establish specific times in the early morning and late afternoon for construction vehicles to access the site to prevent additional traffic during drop-off and pick-up times.

Maintaining Safety + Accessibility

To further enhance safety, the implementation of temporary walkways and clear signage successfully maintained a distinct separation between the operational areas of MPHS and the construction zone. These efforts ensured that students and staff could navigate the campus safely during the expansion project.
